Building and Operating
a New D4 Motorway
32 km of a new motorway will be built and 16 km of the current section modernised for enhanced traffic information and increased driver safety

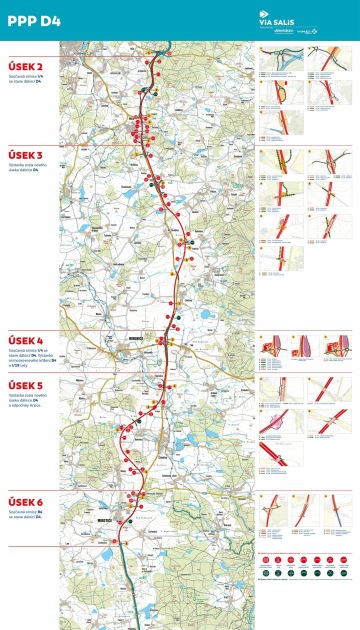

PHASES OF PROJECT
SECTION No.2 Háje - Milín
2021 construction beginning - 2024 opening operation
The current I/4 road will become the D4 motorway
SECTION No.3 Milín - Lety
2021 construction beginning - 2024 opening operation
Construction of a completely new section of the D4 motorway
SECTION No.4 Lety - Čimelice
2021 construction beginning - 2024 opening operation
The current I/4 road will become the D4 motorway
Construction of the off-ramp crossing of D4 and I/19 Lety
SECTION No.5 Čimelice - Mirotice
2021 construction beginning - 2024 opening operation
Construction of a completely new section of the D4 motorwayand the Krsice rest area
SECTION No.6 Mirotice - extension
2020 construction beginning - 2020 opening operation
The current R4 road will become the D4 motorway
CONSTRUCTION PROGRESS
Construction of the new 32 km of the D4 motorway continues as planned and work is underway on all sections
- The topsoil is 95% complete.
- Currently, subsoil rehabilitation is being carried out and earthworks have also started - the construction of excavations and embankments, during which material is being transported or weighed.
- The properties of the soil are being modified, mostly with lime to reduce moisture to make them more usable, stable and stronger.

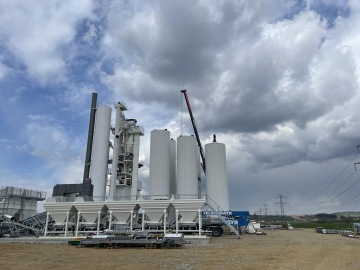

- At the same time, work is also underway on utility relocations and work is continuing on the construction and subsequent start-up of the packaging and concrete plant in Lety.
- Archaeologists are also completing their work in the sections Lety - Čimelice and Čimelice - Mirotice.
- At Milín, preparatory work is underway to remove the rock mass to create a large enough space for the future motorway. The blasting of this massif will start during August and is planned with the utmost consideration for local citizens and drivers. Therefore, a special Scandinavian method will be used which will significantly reduce noise, dust and vibrations.
- Special rigs for drilling piles for future bridge structures have also been installed along the route. The drilling work is taking place simultaneously on 2 bridges.
- Work is also continuing on the construction of diversion roads, the first of which should be operational in the second half of August




Rock massif near Milín, where blasting works are planned

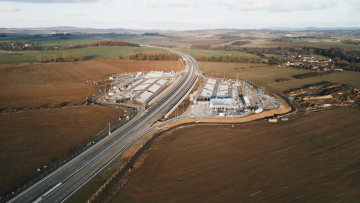

Site of the future rest area at Krsice
Mixing Plant near the Lety intersection
